Bicycle and Pedestrian Plan
Share Bicycle and Pedestrian Plan on Facebook
Share Bicycle and Pedestrian Plan on Twitter
Share Bicycle and Pedestrian Plan on Linkedin
Email Bicycle and Pedestrian Plan link
Overview
The Park City Bicycle and Pedestrian Plan was adopted by city council on September 26, 2024. The plan identifies future projects and initiatives that will make walking and bicycling in Park City safer and more convenient. It establishes clear direction for the City on next steps and how to prioritize investments. With the recommendations from this plan, the City is striving to:
- Serve all bicyclists and pedestrians
- Make useful connections to key destinations
- Improve roadway and paved trail safety

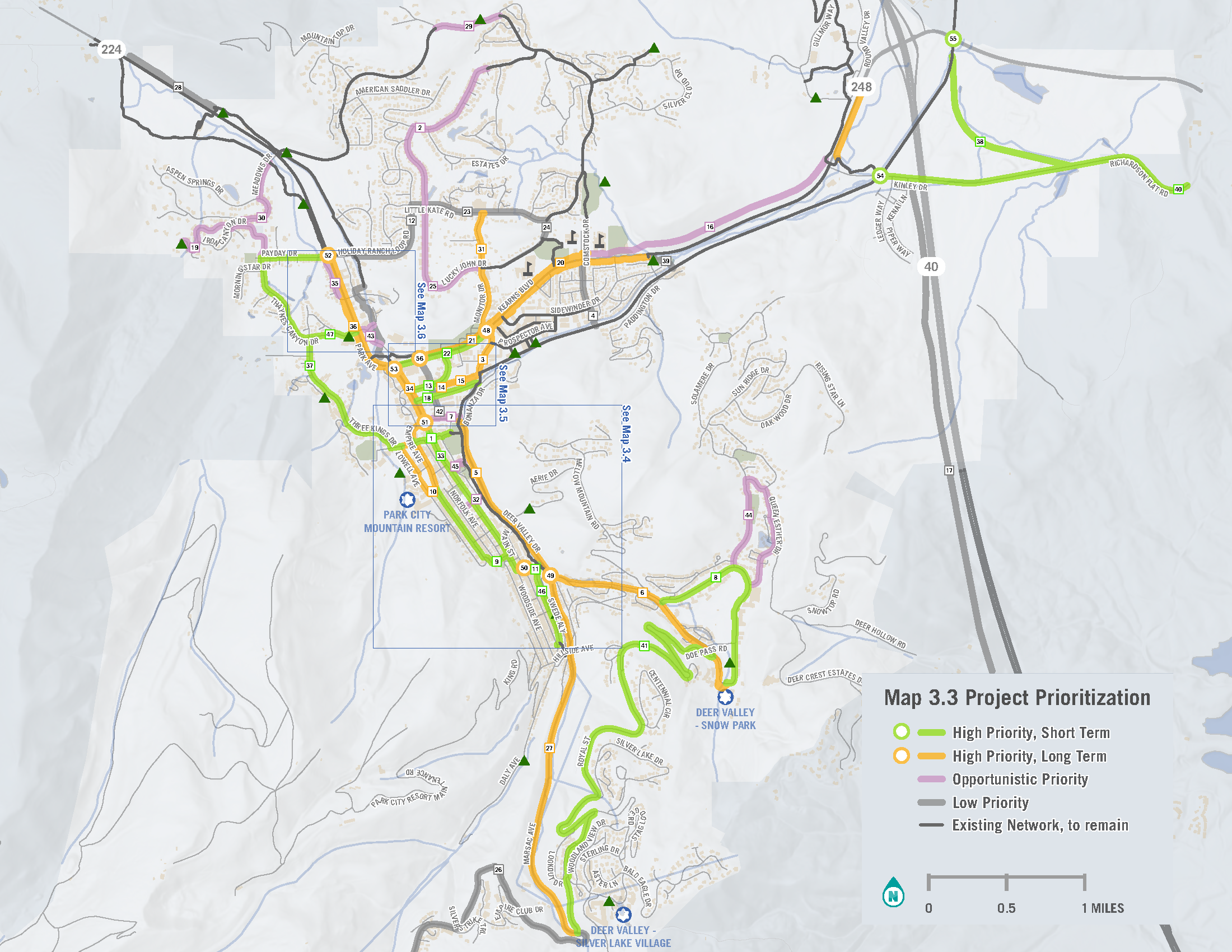

Bicycle and Pedestrian Plan Project Prioritization
We have begun progressing Bicycle and Pedestrian Plan projects, which include:
Street | Project | Status |
---|---|---|
Royal Street | Shared Lane Markings and Signage | Completed |
Empire Avenue | Shared Lane Markings and Signage | Completed |
Park Avenue | Roadway, bicycle, and pedestrian striping. Wayfinding. | In progress - anticipated installation Summer 2026 |
Thaynes Canyon Dr | Multi-use pathway | Phase 1 completed, Phase 2 in progress |
Monitor Drive | Multi-use pathway | In progress |
Little Kate | Multi-use pathway | In progress |
